Drone Solar Ground Mount Survey India Sub-cm Topographic Data

Inaccurate site surveys miss terrain complexity and those errors propagate through panel placement, cable routing, and civil design. Lesoko delivers aerial photogrammetric surveys producing orthomosaic, DEM, topolayout, and full contour data for ground mount solar projects across India. 2.3+ lakh hectares surveyed. Licensed pilots. <1cm accuracy with RTK GPS and verified GCPs. Single-vendor coverage across the EPC project lifecycle from ground mount site survey through construction monitoring to post-commissioning thermal inspection.
2.3+ lakh
Hectares Surveyed
5 Lakh+
Safe Drone Flights
34+ GW
Solar Asset Inspected

210+ Cr

Saved in Operational Costs

<1cm

Survey Accuracy (RTK GPS + GCPs)

What Is Drone Solar Ground Mount Survey?

Drone solar ground mount survey is aerial topographic mapping of large solar project sites using photogrammetric data acquisition. Licensed operators fly systematic grid patterns, capturing georeferenced imagery processed via SfM algorithms into orthomosaic maps, digital elevation models, topolayout maps, contour data, vegetation index, slope analysis, and spot levels delivering GIS/CAD-ready outputs in a single survey operation. The full process constitutes aerial spatial data acquisition. Replacing multiple conventional survey methodologies with a single flight-to-report workflow.

Aerial view of ground mount solar farm showing panel arrays, electrical substation infrastructure, control building, and access road on dry terrain

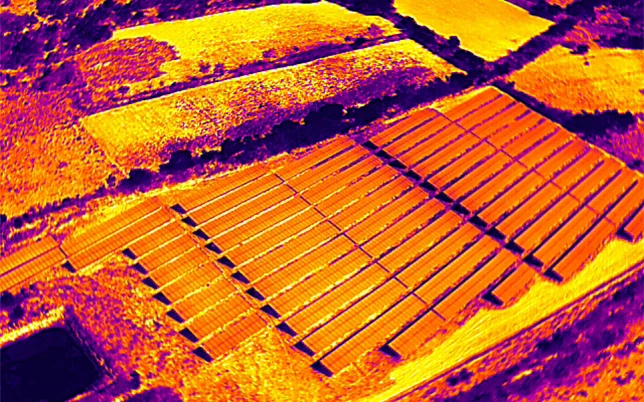

Thermal image of solar panels showing two bright orange-yellow hotspot zones indicating multi-module thermal anomalies across the array

The workflow follows a defined sequence: drone captures high-resolution georeferenced imagery at calibrated flight altitude → SfM photogrammetric processing reconstructs full terrain → eight data layers output simultaneously. Ground Control Points (GCPs) verified with RTK GPS anchor every layer to sub-centimetre spatial accuracy.

Conventional Total Station and DGPS surveys operate at a fixed grid, take weeks to complete on large sites, and produce only spot levels and basic contour data. They cannot access dense vegetation or uneven terrain. Aerial photogrammetry covers the same area 60× faster and delivers data richness no ground-based method can match.

The Problem

Why Conventional Site Surveys Create Project Risk

Incorrect terrain data causes panel placement errors, drainage failures, and structural design rework that surface during construction not during design. An inaccurate contour map at feasibility stage can force costly redesigns after project financing is locked.

For sites above 100 acres, Total Station and DGPS surveys introduce multi-week timeline bottlenecks in EPC schedules. The fixed-grid approach also means survey data gaps in areas teams cannot physically access. A growing problem on sites with thorn vegetation, uneven gradients, and waterlogged boundary zones.

Manual surveys produce only spot levels and basic contour data. They do not generate orthomosaic imagery, vegetation index, slope analysis, or GIS-ready spatial formats. Without these layers, PVsyst energy simulation, shadow analysis, civil cost estimation, and layout design all operate on incomplete information.

Aerial view of large ground mount solar farm surrounded by agricultural fields and tree plantations in Indian rural landscape
Process

How Aerial Photogrammetric Survey Works

From pre-flight planning to final deliverables. Every survey follows a structured, DGCA-compliant workflow.

Mission Planning

Site boundary definition, systematic flight path design, and GCP placement plan calibrated to terrain complexity and required accuracy level.

GCP Deployment

Physical Ground Control Point markers placed across the site. Density determined by terrain type. On sites with thorn vegetation or steep slopes, GCP placement requires additional field time, which is scoped during pre-survey review and reflected in the project timeline before mobilisation.

Regulatory Clearance

DGCA flight permissions verified, NOTAM coordination completed, no-fly zone checks conducted, and site safety assessment signed off before mobilisation.

Flight Execution

A licensed drone operator flies systematic image capture with a high-resolution RGB camera and RTK GPS module. Calibrated overlap at defined flight altitude ensures the point cloud density required for sub-centimetre accuracy.

Photogrammetric Processing

SfM algorithms generate a dense point cloud, which is used to produce the orthomosaic, DEM, and DSM simultaneously. Full terrain reconstruction with GCP-anchored accuracy validation and checkpoint residual reporting.

Deliverable Generation

Complete 8-layer output are orthomosaic, topolayout, DEM/DTM, contour map, vegetation index, slope analysis, spot level grid, and comprehensive report.

Deliverables

What You Get from Every Ground Mount Solar Survey.

Every ground mount solar site survey delivers eight data layers in a single operation:

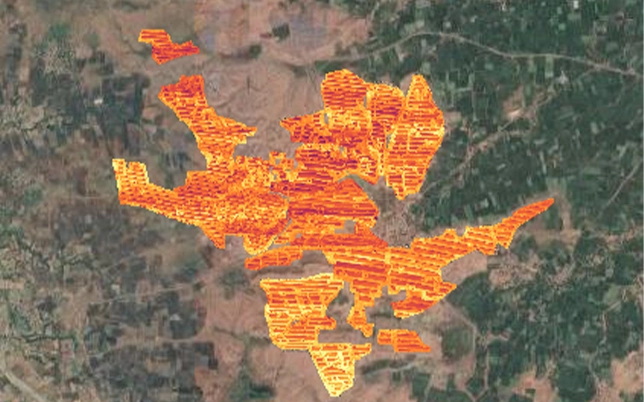

Georeferenced orthomosaic map of a ground mount solar site in India — high-resolution aerial image showing complete site extent, boundary, and panel layout area

Georeferenced Orthomap

High-resolution aerial image mosaic georeferenced to sub-cm accuracy. Use: visual site assessment, existing structure identification, GIS analysis input.
Topolayout annotation on forested terrain orthomosaic showing route lines, zone classifications, drainage paths, and land use boundaries

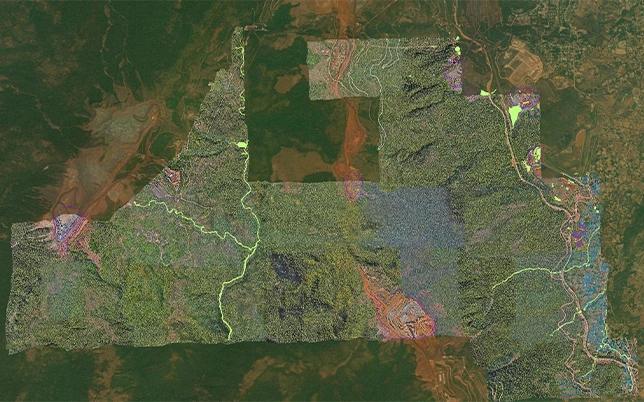

Topolayout Map

Annotated topographic layout showing terrain features and proposed array zones. Use: solar panel placement, string layout design, cable routing corridor planning.

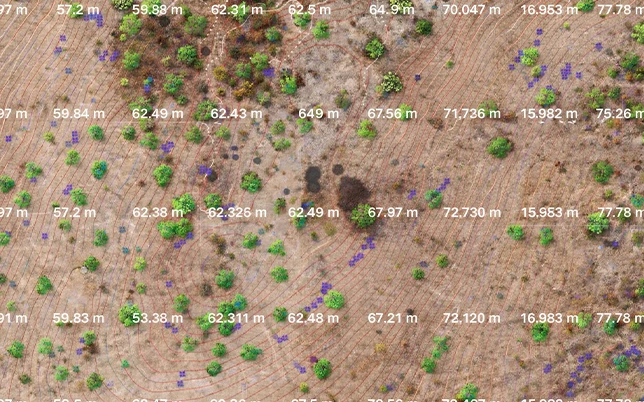

Spot level survey grid showing elevation readings in metres annotated across dry terrain orthomosaic with GCP marker positions visible

Contour Map with Spot Levels

Contour maps with precise spot level data at 5m×5m or 10m×10m grid spacing as per project requirements. Providing the elevation density needed for accurate structural pile design and earthwork estimation.

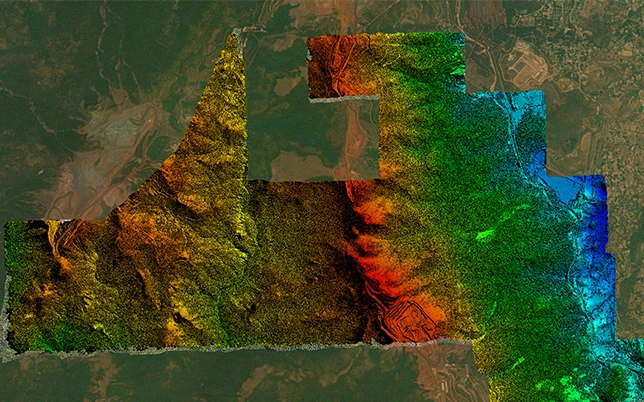

False-colour DEM showing terrain elevation gradient from red-orange high ground to green-blue lower terrain across solar survey site

Digital Elevation Model (DEM / DTM)

Full terrain elevation at adjustable grid resolution. The DTM (Digital Terrain Model) filters to bare-earth surface — the critical input for structural foundation planning, drainage design, and earthwork estimation. On sites with dense canopy, the DSM (Digital Surface Model) is processed separately to isolate true ground elevation.

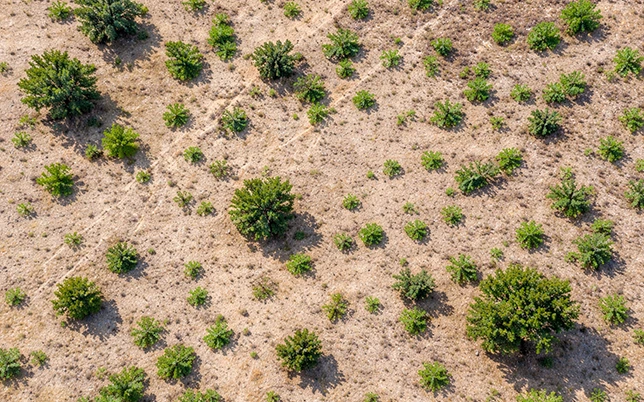

Aerial nadir view of dry sandy terrain with scattered thorn bushes and faint vehicle tracks typical inaccessible solar site terrain

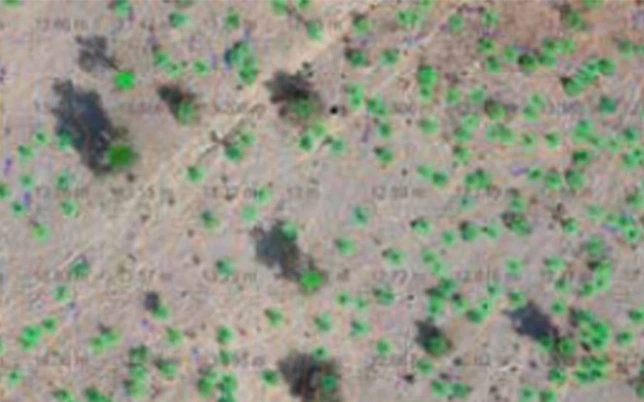

Vegetation Index & Tree Count

AI-powered NDVI analysis delivering exact tree, bush, and shrub counts across the survey area. Critical for shadow modelling, land clearance cost estimation, and compensation assessment for land acquisition.

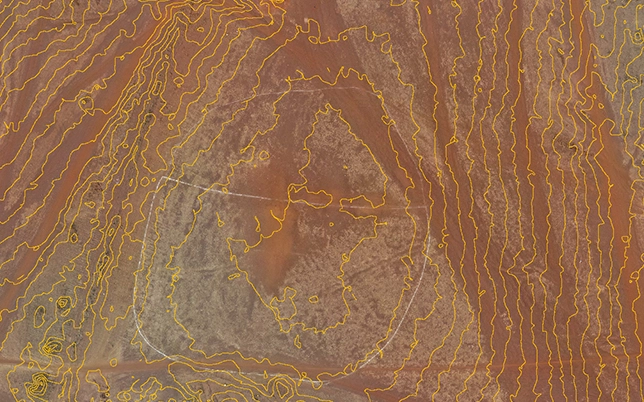

Orange contour lines overlaid on arid desert terrain orthomosaic with circular site boundary marker showing gradient variation

Contour Map

Topographic contour maps at 0.1m, 0.5m, or 1.0m intervals as per your project requirements. Essential for identifying undulations, planning bund construction, and optimising panel tilt angles across the site.
Contour lines overlaid on aerial orthomosaic of dense forest canopy showing elevation values at 700–750m intervals

Slope Percentage Map

Site-wide slope percentage analysis identifying terrain gradient across the full survey area used for optimal panel tilt planning, identifying areas requiring special mounting systems, and access road design.
Aerial view of two ground mount solar array blocks separated by access corridor on dry terrain, with surrounding agricultural fields

Handheld Camera Site Images

Ground-level site photographs documenting existing infrastructure, access points, water bodies, electrical poles, and boundary features providing visual context for permitting.
Operational Value

What You Get With Aerial Photogrammetric Survey

Drone Survey vs Traditional Methods

Why Drone Survey Wins — Every Time

The comparison isn’t close. Drone-based ground mount solar surveys eliminate the speed, accuracy, and access limitations of both DGPS and Total Station methods.

Parameter Lesoko Drone Survey DGPS Survey Total Station
Time for 1,000 acres 4 working days ~30 working days ~25 working days
Accuracy <1cm (sub-centimetre) 3–5cm 5–10cm
Control points needed <200 for 1,000 acres 10,000+ 8,000+
Grid adjustability Fully adjustable (1m–10m) Fixed grid only Fixed grid only
Vegetation index / tree count AI-powered NDVI Not available Not available
Inaccessible terrain coverage Full coverage Gaps in data Gaps in data
PVsyst-compatible DEM Included Partial Partial
AutoCAD DWG export Standard Extra cost Extra cost
Technical Depth

Methodology and Quality Assurance

Flight altitude, image overlap percentage, and GSD (Ground Sampling Distance) are calibrated to the project’s required output resolution. Typically 2–3 cm/pixel for solar site feasibility work. GCP density is adjusted based on terrain type: flat agricultural land requires fewer control points than hilly or multi-gradient sites. For projects requiring maximum positional accuracy in signal-constrained terrain, PPK (Post-Processing Kinematic) processing is available as an alternative to live RTK particularly useful on sites where satellite connectivity is inconsistent.

Post-flight, SfM processing generates a dense point cloud from which the orthomosaic, DEM, and DSM are derived simultaneously. Accuracy validation runs at every stage: GCP residuals are checked against tolerance thresholds, and independent checkpoints verify the final DEM before delivery. On active or partially installed sites, morning and late-afternoon flight windows reduce solar panel glare and shadow interference during image capture. Client data is delivered exclusively to the commissioning team.

Technical Review

Survey methodology reviewed by Lesoko's DGCA Remote Pilot Certificate holders with operational solar survey experience across Gujarat desert terrain, Karnataka hill gradients, Rajasthan large-site logistics, and Tamil Nadu coastal scheduling and verified against multi-state project deployments.

Audience

Who this service is for

EPC Contractors

  • Responsibility: Site feasibility, structural layout design, civil engineering preparation for ground mount solar projects
  • Core challenge: Inaccurate topographic data causes layout errors, drainage failures, and structural rework discovered during construction
  • Operational value: 4-day delivery, GIS/CAD-ready data, topolayout for panel placement, contour for civil estimation

Solar Project Developers / IPPs

  • Responsibility: Site selection, feasibility documentation, lender technical reporting for independent power projects
  • Core challenge: Manual surveys miss terrain complexity, vegetation density, and drainage risk all material to project finance models
  • Operational value: Vegetation index, slope analysis, and DEM for PVsyst simulation, shadow studies, and environmental reporting sized for utility-scale projects above 50 MW. See also: drone construction monitoring for the next project phase.

Lender Technical Advisors

  • Responsibility: Technical due diligence for project financing, asset acquisition, and asset transfer transactions
  • Core challenge: Incomplete or inaccurate site documentation creates measurable financial and technical risk at underwriting
  • Operational value: Geo-accurate orthomosaic, contour maps, and comprehensive survey reports meeting lender-grade documentation standards for project finance due diligence
Coverage

Pan-India Survey Deployment

Pan-India operations with deployment capability within 48 hours for sites above 50 MW equivalent area. Completed projects across Tamil Nadu, Karnataka, Gujarat, Rajasthan, Maharashtra, Andhra Pradesh, Telangana, and Madhya Pradesh. Same-day deployment available in Chennai, Bengaluru, Hyderabad, and Ahmedabad for urgent requirements.

Dedicated geo-specific coverage for major solar clusters: Gujarat (Charanka, Banaskantha), Rajasthan (Bhadla, Jodhpur), Karnataka (Pavagada), Andhra Pradesh (Kurnool).

Each terrain presents distinct operational requirements: Rajasthan desert sites require dust-adjusted flight planning and post-flight image quality screening. Karnataka hilly terrain requires higher GCP density and additional accuracy checkpoints. Tamil Nadu coastal sites factor monsoon season ground saturation into GCP placement and scheduling.

Ground Mount Solar Survey Is the First Step Every Solar Project Needs

Trusted By Industry leaders

Pricing

What Determines Survey Cost?

Project pricing is structured on a per-hectare or per-acre basis, with volume tiering for larger sites. The primary driver is site area larger projects receive proportionally lower per-hectare rates due to mobilisation efficiency.

Survey cost is typically a fraction of the rework and delay costs that result from inaccurate topographic data at feasibility stage with 2.3+ lakh hectares of survey experience, this is a consistent observation across project types.

To receive an accurate proposal, share your project area, site location, terrain type, and required deliverables. No upfront commitment required.

Report Samples

Sample Deliverable Previews

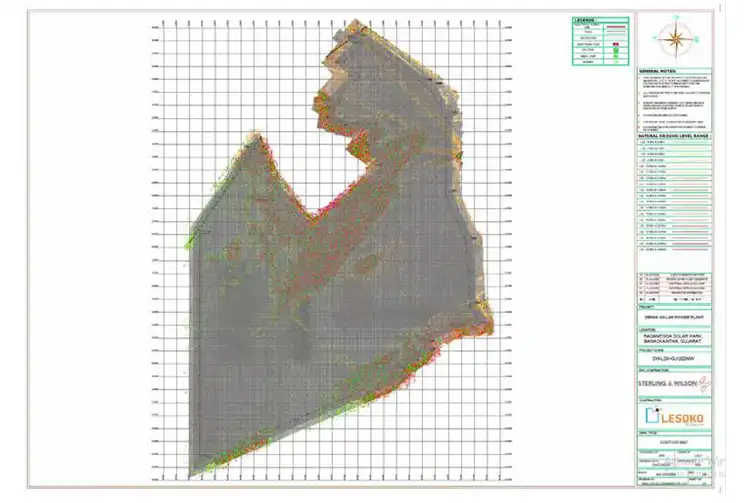

Survey contour map report for Radhanpura Solar Park Banaskantha Gujarat 220MW. Lesoko and Sterling & Wilson

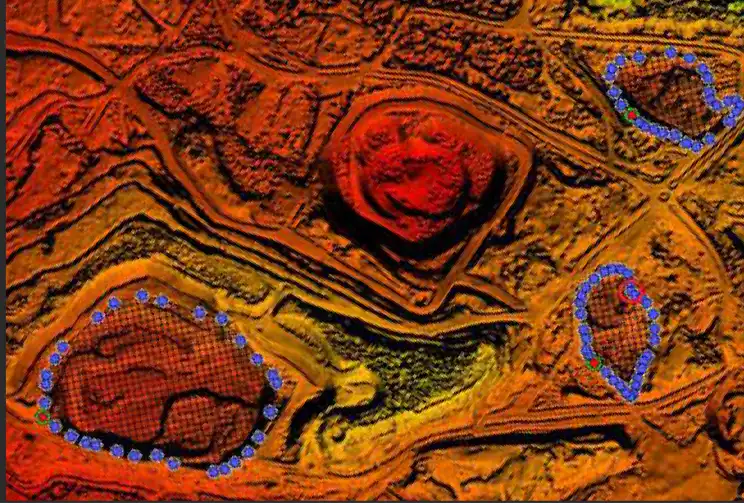

False-colour DEM showing elevated terrain mounds with blue circular boundary markers for ground mount solar site survey

Request a Survey Proposal for Your Solar Site

Free · No obligation · Quote in 24 hours

Phone/ Whatsapp

+91 78457 26375/ 7845726374

Email Us

sales@lesoko.in

Head Office

T. Nagar, Chennai, Tamil Nadu 600017

Get a Scoped Proposal

Frequently Asked Questions

Drone ground mount solar survey delivers orthomosaic maps, digital elevation models (DEM/DTM), topolayout maps, contour maps, vegetation index (NDVI), slope analysis, and spot level surveys — all in GIS/CAD-native formats (GeoTIFF, DXF, KML, Shapefile). Together, these layers provide everything needed for solar array layout design, civil engineering input, and lender-grade site documentation.

Aerial photogrammetric survey with RTK GPS (or PPK where required) and verified Ground Control Points achieves <1cm accuracy. Comparable to Total Station and DGPS results. The key advantage is data richness: drone survey delivers orthomosaic, DEM/DTM, vegetation index, and slope data in a single operation, while Total Station captures only spot levels and basic contour. Survey speed is also 60× faster, with adjustable grid resolution versus a fixed conventional grid.

Complete reports are delivered within 4 days for a 1,000-acre site from flight execution through to final deliverables. Total Station/DGPS surveys typically take approximately 30 days for the same area. Expedited delivery is available for project-critical timelines. Pan-India deployment is possible within 48 hours for sites above a defined project threshold.

Yes. Drone survey accesses dense forest, thorn vegetation, steep gradients, and waterlogged terrain that Total Station teams cannot safely reach. Heavy canopy requires additional processing to separate the Digital Surface Model (DSM) from the true bare-earth Digital Terrain Model (DTM). This additional requirement is assessed during pre-survey site review and factored into timeline and cost before deployment.

A topolayout map is an annotated topographic layout overlaying survey terrain data with proposed solar array zones, access roads, cable routing corridors, and site boundary. It is derived from the orthomosaic and DEM and delivered in GIS/CAD-compatible formats. EPC engineers use it directly for panel placement, string layout optimisation, and civil planning reducing layout iteration cycles at detailed engineering stage.

Yes. Orthomosaic and DEM outputs can be imported into PVsyst for 3D scene creation, shadow analysis, and energy yield simulation. Slope analysis and topolayout maps directly support panel tilt optimisation and row spacing design. Project developers typically complete feasibility energy modelling before committing to detailed engineering. Catching layout and shading issues before pile foundations are specified.

Ground Control Points (GCPs) are precisely surveyed physical markers distributed across the site before drone flight. They anchor aerial imagery to real-world geographic coordinates, ensuring the orthomosaic, DEM, and contour outputs are spatially accurate and not subject to positional drift. GCP density is calibrated to terrain complexity flat agricultural sites require fewer control points than hilly or multi-gradient terrain. Independent checkpoints verify the final DEM against tolerance thresholds before the report is delivered.

A Digital Surface Model (DSM) captures the elevation of everything visible from above including tree canopy, shrubs, and existing structures. A Digital Terrain Model (DTM) represents the bare-earth ground surface only. For solar site planning, the DTM is the critical input for structural foundation design, drainage engineering, and earthwork volume estimation. On sites with dense vegetation, SfM processing separates the DSM from the bare-earth DTM. A step that is scoped during pre-survey review and factored into the project timeline.

Ground Sampling Distance (GSD) is the real-world size represented by one pixel in the orthomosaic typically 2–3 cm/pixel for solar site feasibility surveys at standard flight altitude. Lower GSD means higher spatial resolution and more precise terrain modelling. GSD is determined by flight altitude and camera sensor specification, and is calibrated to the project’s required output resolution before each flight. Higher-resolution surveys are specified when finer structural detail is required, such as for pile foundation design on complex terrain.

Yes. Georeferenced orthomosaic, DEM, contour data, and the comprehensive survey report meet lender-grade documentation standards required for project finance due diligence, asset acquisition, and technical review by independent engineers. The survey report includes full accuracy validation, GCP residuals, flight parameters, and methodology documentation. NDA arrangements are available for sensitive projects at the proposal stage.
